How to Turn Meeting Notes and Decks Into Requirements

ยท 8 min read

To turn call transcripts, slide decks and emails into requirements, work in five passes: collect and label every source, pull out statements, decisions and questions, rewrite each need as one testable line, record what is still unknown, and keep a link from each requirement back to where it came from. AI can do much of the first pull for you, but you still have to check every line it produces against the source.

The method below works with a spreadsheet and a highlighter. The last section covers where AI speeds it up and where it needs a careful eye.

The problem with raw meeting material

Meeting material is full of requirements, but almost none of them are written as requirements.

The goal is not to summarize all of it. It is to extract the parts someone will build and test, and to make the rest visible as questions.

Step 1: collect and label the sources

Before reading anything closely, put every source in one list and give it a short label.

Label Source Date Who spoke or wrote it
T1 Kick-off call transcript 3 Mar Sponsor, ops lead, IT lead
T2 Call with dispatch supervisors 6 Mar Two supervisors
D1 Sales deck, "Field app vision" Feb Sales director
E1 Email thread on the dispatch API 4-7 Mar IT lead, vendor

The labels matter later. Every requirement you write will carry one or more of them, so anyone can check where it came from and who said it. Note who was in each conversation, because a statement from the person who approves the budget weighs differently from a passing comment.

If a source is a recording without a transcript, transcribe it first. Working from memory of a call is where invented requirements come from.

Step 2: pull out statements, decisions and questions

Read each source once and mark three kinds of line. Copy each into a working sheet with its source label and, if you can, a short quote.

Do not rewrite yet. Keep the speaker's words. At this stage you want coverage, not polish, and the quotes will help you settle arguments later ("the ops lead said X on 3 March").

When two sources say different things, record both and add a question. Do not choose silently.

Step 3: rewrite them as testable requirements

Now turn each need into a requirement that a tester could pass or fail. A good line is short, covers one thing and states an observable result. The requirements standard ISO/IEC/IEEE 29148 lists qualities such as necessary, singular, unambiguous and verifiable; in practice, "can someone check this?" catches most problems.

One simple pattern, from the EARS approach developed at Rolls-Royce, is: When [trigger], the [system] shall [response].

Raw note (source) Requirement
"No signal in basements, lost a day of forms" (T1) The technician app shall let a technician record a visit without a network connection and sync it when the connection returns.
"Supervisors find out about declines by phone, too late" (T2) When a technician declines a visit, the dispatcher board shall show the visit as unassigned with the decline reason within one minute.
"We keep the current dispatch system" (T1, E1) Constraint: visits shall be created and closed in the existing dispatch system through its API.
"Customers dispute that we were there" (T2) The app shall capture the customer's signature and attach it to the closed visit.

These examples are invented for this article. Then add the fields that make a requirement manageable:

If a number in an acceptance criterion did not come from a source, mark it as a proposal. "Within one minute" should be confirmed by someone, not quietly adopted.

Here is what the result can look like once the lines are numbered and typed. This is the requirements section of an example report for Fieldwise, an invented field-service app; every name and figure in it is made up:

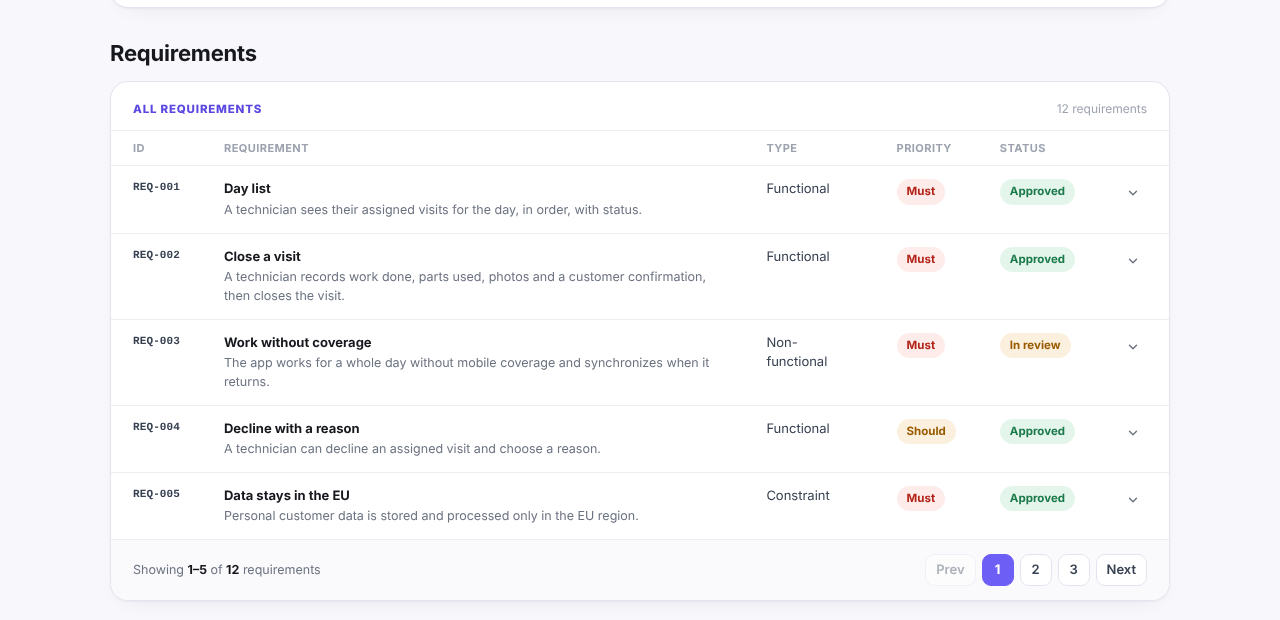

Requirements table from the Fieldwise example report, with REQ-001 to REQ-005, their type (functional, non-functional, constraint), priority and status

Step 4: record what is still unknown

Most of the value of this exercise is in what you could not write. Every question from step 2, and every requirement you had to guess at, goes into an open questions log.

For each item record:

Example: "Do subcontractors use the app? Affects login, permissions and licence count. Ask: ops lead. Until answered: assume employees only."

In the same invented Fieldwise project, open questions sit next to risks and blockers, each linked to the stage it affects:

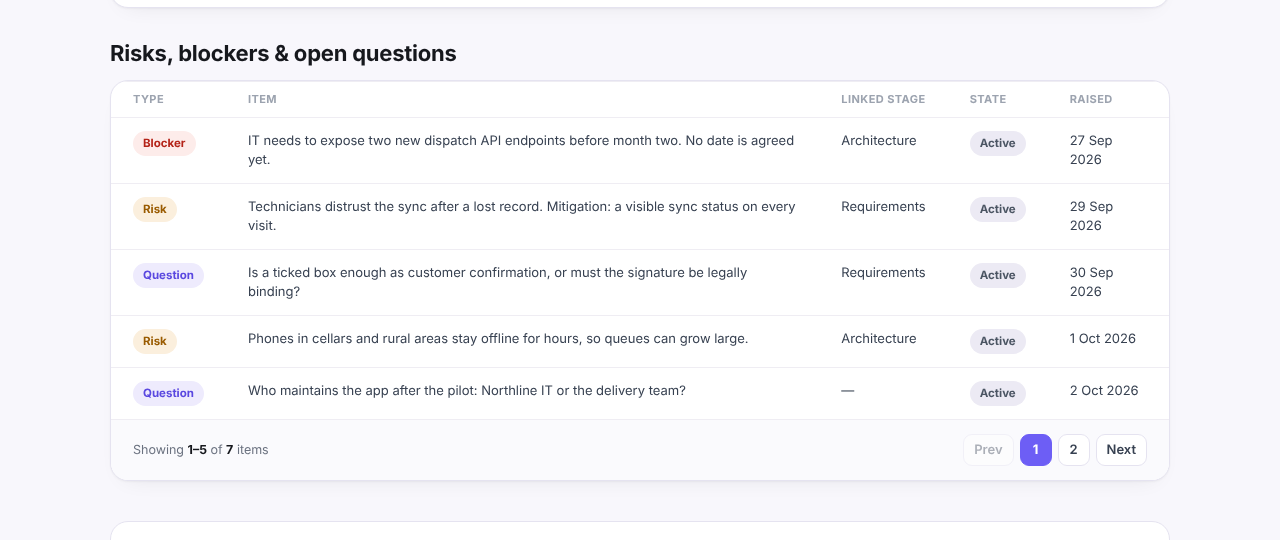

Risks, blockers and open questions from the Fieldwise example report, such as whether a ticked box is enough as customer confirmation

Assumptions you make to keep moving should be visible in the same place. An estimate that rests on "employees only" changes if the answer is "and 40 subcontractors". The discovery phase checklist has a section of questions that helps find these gaps.

Finally, read the requirement list back against the sources once more. Look for needs that appear in a transcript but in no requirement, and requirements with no source label at all. The second kind is often an idea someone had while writing, which may be fine, but should be agreed rather than slipped in.

Where AI helps, and what you must still check

AI is good at the slow parts of steps 2 and 3: reading a long transcript, finding the sentences that state a need, grouping similar points and proposing a first wording. It is also useful for a second read ("which statements in this transcript did my list miss?").

It needs checking in predictable places:

Discovery Phase AI is one way to do the first pass. You upload transcripts, decks, documents or images when you create a project; they are analyzed in memory and not stored, and the AI drafts stakeholders, goals, users, journeys and requirements for you to review. It is instructed to draft a requirement only when the source states it, never to invent acceptance criteria or numbers, and to leave a field empty rather than guess, and you keep or uncheck each drafted item before anything is saved. Even so, steps 1 and 4 remain yours: knowing who said what, and writing down what nobody has answered yet.

For where this work sits in the larger process, see the discovery phase in software development.
