SOW vs Discovery Phase: Which Comes First, and Why

ยท 8 min read

A statement of work (SOW) fixes deliverables, price and acceptance for a piece of work; a discovery phase is the short, separately paid step that finds out what that work actually is. When the requirements are unclear, the order is discovery first, then the SOW for the build, written from what discovery found. Signing a fixed SOW before that usually means pricing guesses, and one side pays for them later.

This article describes common practice, not legal advice. Have a lawyer review contract wording that matters to you.

What a SOW is, and where it breaks down

A SOW describes what will be delivered under a contract: the deliverables, the dates, how each one will be accepted, and usually the price and payment terms. A template published by the Georgia Technology Authority, for example, describes it as identifying goals, dependencies, constraints, deliverables and acceptance criteria, without describing how the work will be done. It often sits under a master services agreement that holds the legal terms.

That works well when both sides know what they are buying. It breaks down when they do not:

None of this is a drafting problem. The SOW is precise about things that have not been worked out yet.

What a discovery phase agreement is

A discovery phase agreement is a small contract, or a short SOW of its own, for the discovery work only. It is usually two to six weeks long and buys a defined set of outputs rather than software. It typically covers:

The point of the agreement is that its own scope is clear even when the product's scope is not. If you need a reminder of what the work itself involves, see what a discovery phase is in software development.

Why a fixed SOW before discovery goes wrong

Estimates made before the requirements exist are wide by nature. In Steve McConnell's Cone of Uncertainty, an estimate made at the initial concept stage can be off by up to 4x in either direction, and the range narrows as requirements and design are completed (Construx). A fixed price signed at that point has to absorb that uncertainty somewhere.

In practice it goes one of three ways:

What the vendor does What happens next
Prices low to win the work Change requests pile up, or the vendor cuts corners to stay in budget
Prices high to cover the unknowns The client overpays for risk that may never materialise, or chooses someone cheaper
Prices fairly but scopes vaguely Both sides argue about what was included when the build is half done

A discovery phase does not remove uncertainty, but it moves the expensive questions to a point where they are cheap to answer: before anyone has written code.

The sequence: discovery, SOW, build

The simplest working sequence has three steps.

  1. Sign a discovery agreement. Short, with a clear fee and clear deliverables. The client commits a small, known amount.
  2. Write the build SOW from the discovery results. The deliverables come from the agreed requirements, the acceptance criteria from the requirements' own criteria, the price from the estimate range and its assumptions, and the exclusions from the "out of scope" list.
  3. Build, with a change process. New ideas go through a written change request with its effect on cost and dates, instead of quietly growing the work.

Discovery also gives both sides a natural decision point. After step 1 the client can go ahead, shrink the first release, run a smaller pilot, take the results to another vendor, or stop. A good discovery agreement says this openly.

The risks found in discovery should travel into the SOW too, either as assumptions or as named exclusions. This is what a risk list looks like in the public example report, for an invented project called Fieldwise: a blocker on another team's API, a mitigation for a user trust risk, and open questions with no owner yet.

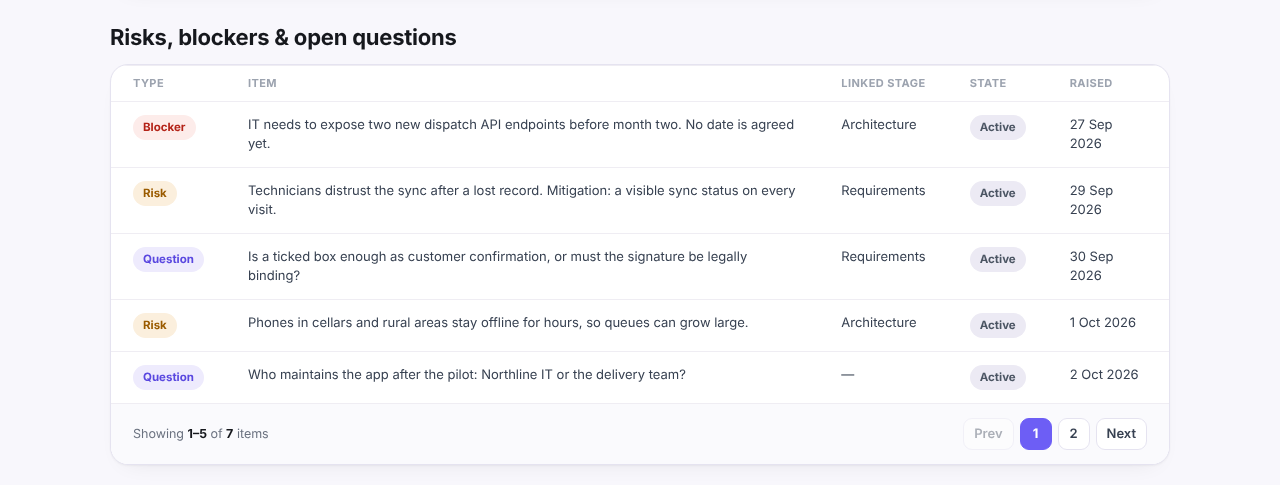

The Risks, blockers and open questions table of the example report for the invented Fieldwise project, listing a blocker, two risks and two questions with linked stage, state and date raised

Each of those lines changes how the build SOW should be written. The API blocker becomes an assumption with a date; the signature question must be answered before the acceptance criteria for closing a visit can be final.

What goes in each document

Discovery agreement Build SOW
Purpose Find out what to build and what it will cost Deliver the agreed software
Length of work Usually weeks Usually months
Deliverables Documents and decisions: goals, requirements, architecture outline, roadmap, risks Working software, by milestone
Acceptance Deliverables reviewed and accepted by the client Requirements' acceptance criteria pass
Price Fixed fee or capped time and materials Fixed per milestone, or time and materials, based on the discovery estimate range
Assumptions Access to people, material and systems The assumptions listed in the discovery estimate
Out of scope Building software The "out" and "later" lists from discovery
Change handling Rarely needed; extend or stop Written change requests with cost and date impact

Two details are worth getting right. First, reference the discovery output in the build SOW by version and date, so everyone knows which requirements were priced. Second, copy the assumptions over word for word; they are what makes the price fair when one of them turns out to be wrong.

How to sell discovery to a client who wants a quote

Clients ask for a fixed quote because they need a number for their budget, not because they enjoy fixed-price contracts. Give them a number they can use, and explain what it buys.

If you run discovery for several clients at once, keeping each one's material and output in one place helps. Discovery Phase AI, for example, can draft the discovery stages from a client's existing decks, documents and call transcripts, and exports the result as a report in PDF, Word, PowerPoint or Markdown; the SOW itself is still yours to write.
