Discovery Phase Deliverables: What You Should Receive
ยท 11 min read
A software discovery phase should end with ten concrete deliverables: a stakeholder map, background, an executive summary, a problem statement, goals with success metrics, users with journeys and flows, prioritized requirements with acceptance criteria, architecture diagrams and decisions, rough UI screens, and a roadmap with estimates, assumptions and risks. If a proposal promises only "a discovery document" or "a specification", ask which of these it includes and how each will be judged.
This list works both ways. A client can use it to check an agency's proposal, and an agency can use it to say precisely what it will hand over. For the process that produces them, see the discovery phase in software development.
The ten deliverables at a glance
| No. | Deliverable | What it answers | Done when |
|---|---|---|---|
| 1 | Stakeholders | Who decides, who is affected, who can say no | You know who signs off |
| 2 | Background | Why the project exists, what was tried before | A new team member understands the context |
| 3 | Executive summary | The problem, the proposal, the cost range, the decision needed | A sponsor can read it in two minutes |
| 4 | Problem statement | Who has which problem, how often, at what cost | It names no solution and cites evidence |
| 5 | Goals and success metrics | What changes, measured how, by when | Every goal has a number, a baseline and a date |
| 6 | Users, journeys and flows | Who uses the product and what they do | The main journey of each user is mapped |
| 7 | Requirements | What the product must do | Every Must has acceptance criteria and a goal |
| 8 | Architecture and decisions | How it fits together and why | Integrations are known and key choices recorded |
| 9 | UI screens | What the key screens contain | Each screen is tied to the requirements it covers |
| 10 | Roadmap, estimates and risks | When, how much effort, what could go wrong | Estimates are ranges with stated assumptions |
The discovery phase template describes each section in more detail. The screenshot below shows the start of a finished report for Fieldwise, an invented field-service app used in our example report; all names and figures in it are made up.

The deliverables do not need to be ten separate files. One document with these sections is easier to read and keep current. What matters is that each section exists and meets its "done when" test.
Problem, goals and success metrics
These are the deliverables a sponsor reads first, and the ones most often left vague.
Problem statement. A useful one says who is affected, what goes wrong, how often and what it costs, without describing the solution. "Dispatchers learn about declined visits by phone, often hours late, so about one visit in ten is missed" (an invented example) is a problem statement. "We need a mobile app" is not. Ask what evidence supports it: data, support tickets, interview quotes.

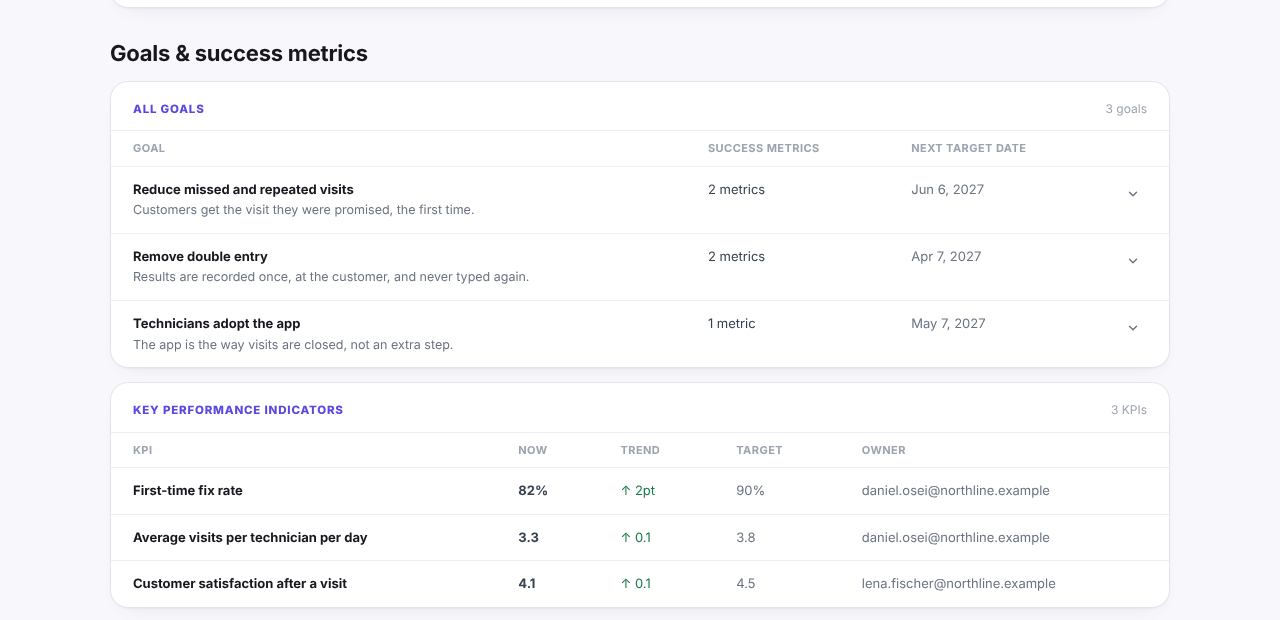

Goals and success metrics. Two or three goals is usually enough. Each needs a metric with today's value, a target and a date. Without a baseline you cannot tell later whether the project worked. Key performance indicators (KPIs) are the figures someone keeps watching after launch, with a named owner.

How to judge them:
- Can you tell, from the goal alone, how it will be measured?
- Is the baseline real (measured) or estimated? If estimated, is that stated?
- Do the stakeholders agree which goal matters most?
Users, journeys and flows
This deliverable shows who uses the product and how. It typically has three parts:
- Users and actors, each with goals and pain points. "Technician" and "dispatcher" are actors; so is an external system that sends data.
- Journeys: the steps a user takes to reach a goal, including where they get stuck today.
- Flows: key processes drawn as diagrams, so edge cases (a declined visit, a lost connection) are visible.
How to judge them: pick the most important user and follow their journey step by step. Every step should either be supported by a requirement or be explicitly out of scope. Ask whether unusual cases are covered: first use, errors, permissions, empty states.
Requirements with priorities and acceptance criteria
The requirements list is usually the longest deliverable and the one developers use most. Each requirement should have:
- an ID, a short title and a one-sentence description;
- a type: functional (behaviour), non-functional (quality such as performance or availability) or constraint (a limit you cannot change, such as a regulation or a mandated system);
- a priority, commonly MoSCoW (Must, Should, Could, Won't);
- acceptance criteria that a tester could pass or fail;
- the goal it supports, and an owner.
How to judge it:
- Testability. "The app is fast" fails; "the day list loads in under two seconds on a 4G connection" passes.
- Priorities. If nearly everything is a Must, nothing has been prioritized. The DSDM guidance behind MoSCoW suggests Musts take no more than about 60% of the effort.
- Traceability. Every Must should trace to a goal, the problem statement or a stakeholder need.
- Non-functional needs. Security, availability, accessibility and data residency are often missing and expensive to add later.
Architecture decisions, roadmap, estimate and risks
Architecture. At discovery stage this is a first technical picture, not a full design. Expect a context diagram (the system and the systems around it), a component view, a list of integrations with their owners, and decision records. A decision record states the question, the options compared, the choice and its consequences; the format popularized by Michael Nygard is a common starting point.
UI screens. Rough wireframes of the three to five screens users meet most. They exist to agree on content and flow, not visual design. Each should name the requirements it covers.

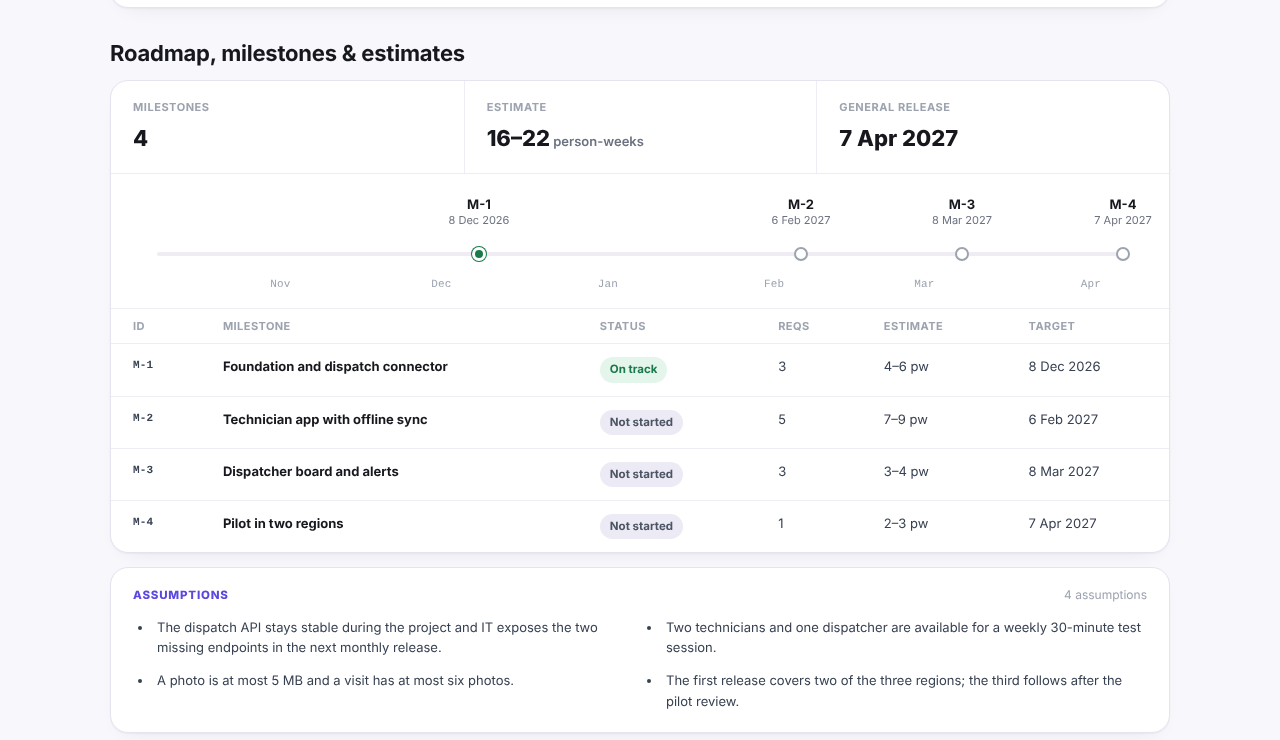

Roadmap and estimate. Milestones that each end with something visible, with dependencies between them and an effort range per milestone. A single number is a warning sign: early estimates carry wide uncertainty, as Construx's write-up of the cone of uncertainty explains. The assumptions behind the range should be written next to it.

Risks, blockers and open questions. Each item needs an owner and a next step. Open questions are a deliverable in their own right: a discovery that ends with none listed has probably not looked hard enough.
What are the deliverables of a discovery phase?
The short answer is the ten in the table above. In practice, people ask the question in three different ways, and the answer changes slightly with each:
- As a client reviewing a proposal: you need the list, plus a "done when" test for each item, so that "a discovery document" cannot mean anything at all.
- As a delivery team: you need to know which deliverables the build team will actually use. Requirements, architecture and UI screens are read daily; the background and the executive summary are read once.
- As a sponsor: you need the executive summary, the problem statement, the goals and the roadmap with its estimate. These four support the decision to build, build less or stop.
Who uses which deliverable
| Reader | Reads first | Returns to |
|---|---|---|
| Sponsor or budget owner | Executive summary, goals, roadmap and estimate | Risks and open questions |
| Product owner | Problem statement, users and journeys, requirements | Priorities and acceptance criteria |
| Developers and tech lead | Requirements, architecture and decisions | UI screens, open questions |
| Designers | Users, journeys and flows, UI screens | Requirements they depend on |
| Testers | Requirements with acceptance criteria | Flows, non-functional requirements |
When the phase ends, the same material goes to the people who build. How to hand discovery over to the development team covers what that handoff should include.
Deliverables in an agile discovery phase
An agile discovery produces the same ten sections, but at a different depth. The aim is direction, not a frozen specification:
- Goals, success metrics and the problem statement are done in full. Everything else is judged against them.
- Requirements become a prioritized backlog. The Musts are written with acceptance criteria; the Shoulds and Coulds stay as rough items that are detailed sprint by sprint.
- Architecture covers the decisions that would be expensive to reverse: integrations, data, hosting and security. It does not try to design every component.
- UI screens are limited to the few screens that carry the main journey.
- Roadmap and estimate stay ranged, and the assumptions behind them are written down.
- Risks and open questions are kept as a living list, reviewed at the start of each sprint.
What an agile discovery should not skip is the written record: goals, scope, assumptions and risks. Discovery phase vs product discovery explains where the two kinds of discovery overlap and where they do not, and PRD vs BRD vs SRS helps you choose the right document type for the requirements.
How the deliverables change with project size
These are rules of thumb, not standards. Adjust them to your risk and your budget.
| Project type | Go deep on | Keep light |
|---|---|---|
| Small MVP | Problem statement, goals, the Must requirements | UI screens, architecture decisions beyond hosting and data |
| Typical product | Requirements, integrations, roadmap with ranges | Visual design |
| Regulated or legacy-heavy | Non-functional requirements, integrations, risks, data and compliance constraints | Nothing: this is where skipped sections cost the most later |
For help writing the sections themselves, see functional requirements examples, non-functional requirements examples, stakeholder analysis, MoSCoW prioritization, how to estimate a software project and the open questions and assumptions log. For what the phase costs, see discovery phase cost.
Red flags in a discovery proposal
When you review a proposal, these are worth a question before you sign:
- "A discovery document" with no list of contents. Ask for the sections and what "done" means for each.
- No goals or metrics. Without them, nobody can judge whether the build succeeded.
- Requirements without acceptance criteria or priorities. This usually means the hard conversations have been postponed to development.
- A single-number estimate. Ask for a range and its assumptions.
- No user research. If no one will speak to the people who use the product, journeys and requirements will be guesses.
- No architecture or integrations section for a product that connects to existing systems.
- No risks or open questions. Every real project has them.
- The output is slides only. Slides are good for a sign-off meeting, but developers need something they can search and reference.
- No sign-off step. It should be clear who approves the result and what happens next: build, a smaller pilot or stop.
The discovery phase checklist turns these into questions you can ask at the end of a discovery.
